Why shift-start kills die casting margins

Furnace pre-heat overlap, holding loads, and the MD spike your incomer meter sees every morning add up in rupees. Industry benchmarks show 15–22% of billed maximum demand can trace to the first 30–40 minutes of shift start. Sequencing fixes it without capex.

die castingmaximum demandshift planningprescriptive energyholding load


The invisible morning spike

06:45. Holding furnaces ramp. Compressors kick in. Quench pumps come online. The incomer meter climbs before the first pour.

Your EMS logs the kVA peak. Finance sees it again on the DISCOM bill as maximum demand charges. Between those two moments, nobody gets a work order: what overlapped, who staggers it, how many rupees per month.

Every die casting plant knows this rhythm. What plant heads rarely quantify is how much of the spike is avoidable overlap, not production demand.

That gap is where margin leaks. On many HT industrial tariffs in India, MD charges can run 30–50% of the monthly bill (industry benchmark). A predictable morning window you can sequence away is not an operations nuisance. It is a cost line.


What the data shows

Across automotive-adjacent die casting units in India, 15–22% of billed maximum demand often traces to the first 30–40 minutes of shift start (industry benchmark, not a plant-specific guarantee). The pattern repeats:

  • Three holding furnaces pre-heating simultaneously

  • Compressors running before moulds are staged

  • Quench and utility loads starting on a fixed clock, not the production schedule

The spike is not random. It is scheduled overlap dressed as startup discipline.

Signal

What it usually means

Benchmark impact

Incomer kW peaks before first pour

Furnace + utility ramp ahead of production

MD charge holds all month

Overlap window 20+ min daily

Multiple assets on fixed timers

₹4–8L/month at typical HT tariff bands [~]

Holding load flat with zero pours scheduled

Furnace hold without batch

Non-production kWh, often 10–20% of furnace load [~]

Compressor hours before MES signal

Air system ahead of need

Adds to shift-start MD stack

These are reference ranges from comparable die casting loads. Your incomer interval data and bill line items replace benchmarks with your numbers.

Why dashboards miss it

Most EMS platforms answer what happened at 06:52 kVA. They rarely answer:

  • Which furnace started how many minutes before the first pour

  • Whether compressor run hours matched any scheduled production signal

  • What the MD ₹ line item would look like if Furnace 2 started 10 minutes later

kWh trends do not change shift behaviour. Prescriptions in rupees do.

> Stagger Furnace 2 pre-heat by 10 minutes vs Furnace 1 on Mon/Wed/Fri. Estimated ₹1.0–1.5L/month in demand charges. Owner: shift supervisor. Effort: schedule change only. Verify: MD kVA and MD ₹ on next billing cycle.

That is the unit of action that closes the loop. Not a chart. A ticket with a name and a bill line to reconcile.

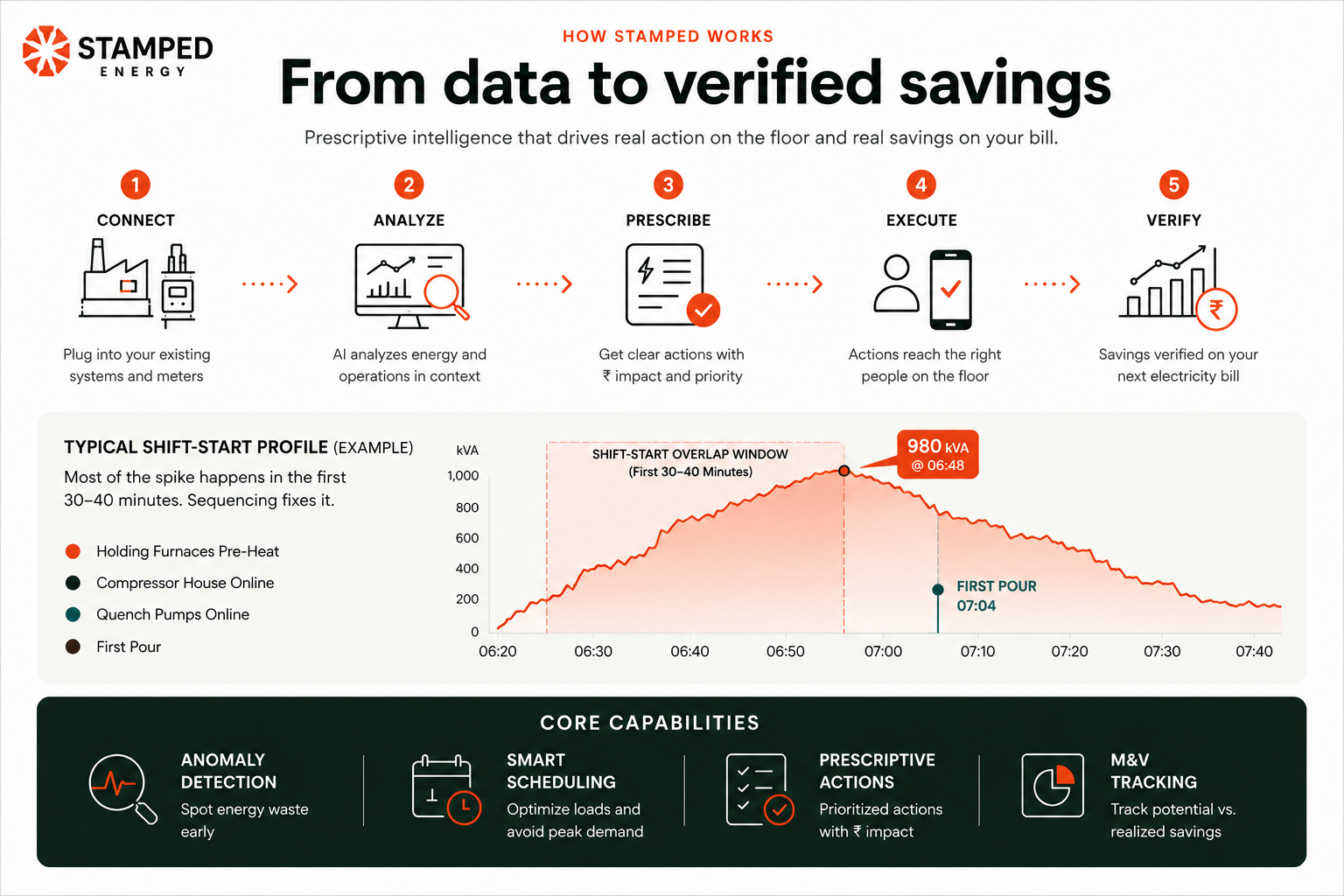

From Data to Verified Savings

From observation to prescription

The fix is usually not a capital project. It is sequencing:

  1. Map ramp curves against actual pour timestamps from MES, machine logs, or manual shift records

  2. Stagger pre-heat windows by 8–12 minutes per furnace so incomer steps up in stages, not one wall

  3. Alert supervisors when holding load exceeds baseline with zero scheduled pours in the next window

  4. Assign and track the change (who shifted which furnace, which shifts, which days)

  5. Verify on the bill — compare MD kVA and MD ₹ against the same production band as the prior month

Stamped Energy runs this loop on data you likely already have: incomer meter, furnace SCADA or panel data, utility bills, and production signals where available. Read-only integration first. No furnace control writes in phase one.

See the five-step flow on How It Works.

Worked example: three-furnace overlap at shift change

Situation: Incomer hits 980 kVA at 06:48 Tuesday. Holding Furnaces 1, 2, and 3 all entered pre-heat between 06:35 and 06:40. Compressor house online at 06:36. First pour logged at 07:04.

EMS view: kVA peak logged. Alarm maybe cleared. No prescribed sequence change.

Stamped prescription (illustrative):

Field

Example

What

Delay Furnace 2 pre-heat start by 10 minutes vs Furnace 1 on Tue/Thu/Sat day shift

Why

6 of last 8 Tuesdays show kVA above CMD between 06:40–07:00; three-furnace ramp overlap before first pour

Who

Shift supervisor + furnace operator

Effort

Schedule change only. Zero capex.

Impact

₹1.0–1.5L/month demand charge component (industry benchmark range; pilot calibrates)

Verify

MD kVA and MD ₹ line vs prior month at similar pour volume

The pattern is predictable. The fix is operational. The proof is on the bill.

Holding loads: the quiet second spike

Shift-start gets attention because the incomer jumps visibly. Holding is the slower leak:

  • Furnace at soak with no mould staged

  • Metal held at temperature between runs while ancillary loads stay fully on

  • Quench and utility circuits running on shift clock, not pour clock

Benchmarks suggest 15–25% of furnace-related energy in some die casting shops can be non-production-linked where setback discipline is inconsistent [~]. That does not always spike MD. It always hits the energy units line.

Prescription shape is the same: tie energy state to production state, quantify ₹/week, assign an owner, verify after the action.

What to measure next week

You do not need a full platform rollout to sanity-check the hypothesis. Pull these for one week:

Metric

How

Why

Incomer kW/kVA

15-minute intervals, first hour of each shift

See peak timing vs production

Furnace ramp start

SCADA tag or operator log timestamp

Compare to first pour

First pour time

MES, machine counter, or shift log

Defines true production start

Compressor run hours

Panel meter or CA kWh sub-feed if available

Holding before staging

Scheduled pours

Production plan or supervisor sheet

Separates hold from run

Simple threshold: if furnace and utility overlap exceeds 20 minutes daily before the first production signal, industry benchmarks suggest ₹4–8L/month may be recoverable at typical HT industrial tariff bands [~]. Validate against your CMD, tariff, and actual interval data.

How Stamped closes the loop

Layer

What you likely have today

What Stamped adds

Data

Incomer meter, furnace panels/SCADA, bill PDF

Time-aligned view: pour timing, kW, tariff cost

Insight

EMS trends, shift notes

Overlap attributed to assets, quantified in ₹/month

Action

Tribal sequencing knowledge

Prescriptions with owner, effort, ₹; WhatsApp to supervisors

Proof

Estimated savings

Potential vs realized ₹ reconciled to DISCOM line items

For the plant head: shift-start becomes a weekly discipline with completion tracking, not a quarterly slide.

For the CFO: a savings ledger tied to bill line items, not kWh charts.

For the electrical team: read-only Modbus/OPC-UA/MQTT to meters and SCADA. Integration path in weeks when data already exists.

Bottom line

Shift-start is not background noise on the incomer chart. It is a margin lever hiding in overlap: furnaces, compressors, and utility loads ramping together on a fixed clock while pours start later.

Quantify the window in minutes. Stagger in minutes. Prove it in rupees on the MD line of your next bill. Industry benchmarks put 15–22% of billed MD and ₹4–8L/month in play at typical die casting loads when overlap runs long daily [~]. Your interval data and one billing cycle replace benchmarks with facts.

Book a discovery call - we review your last three bills, shift-start interval pattern, and whether a single-plant pilot is justified. If the numbers do not support it, we say so.
