Weekend furnace holding: the silent cost in heat treatment

Batch furnaces held at soak over empty weekends can burn 15–25% of furnace energy with no parts scheduled. Industry benchmarks put ₹3–6L/month at risk for a typical three-furnace shop. Calendar-linked ramp-down fixes it without missing Monday dispatch.

heat treatmentfurnacenon-production energyholding loadprescriptive energy

Holding temperature with nothing to hold

Friday, 18:00. The last batch clears quench. Production schedule shows no Saturday batches. The furnace stays at soak anyway, because Monday must not start cold.

Saturday and Sunday pass. Registers hold. Exhaust stacks run. Nobody receives a work order tied to the production calendar.

Monday, finance does not see "weekend habit" on the bill. They see energy units and demand on the DISCOM statement.

Heat treatment shops run batch furnaces like insurance policies: keep temperature through the weekend so Monday does not start from cold. The logic is sound until you line it up against the confirmed batch schedule.

In plants we have baselined, 40% of weekends had zero batches scheduled, yet furnaces maintained full holding load for 48+ hours (observation from comparable batch HT shops; validate against your MES or production log). That is not maintenance energy. That is margin walking out the exhaust.

The rupee math

Furnace holding is not free. For a typical batch shop with three sealed-quench or batch furnaces:

Input

Typical range

Notes

Holding load per furnace

60–120 kW

Soak + circulation + ancillaries [~]

Weekend hours without batches

36–48 hours

Fri evening to Mon pre-heat

Blended industrial tariff

₹8–12/kWh

HT band; validate your DISCOM rate

Monthly waste (3 furnaces)

₹3–6L

When holding runs on empty weekends [~]

Benchmarks also suggest 15–25% of furnace energy can be non-production-linked where weekend setback discipline is inconsistent (industry reference range, not a guarantee for your site).

That number does not always spike maximum demand. It always hits the energy units line. Over a year, it is a cost line the CFO can quantify if you tie furnace registers to the production calendar.

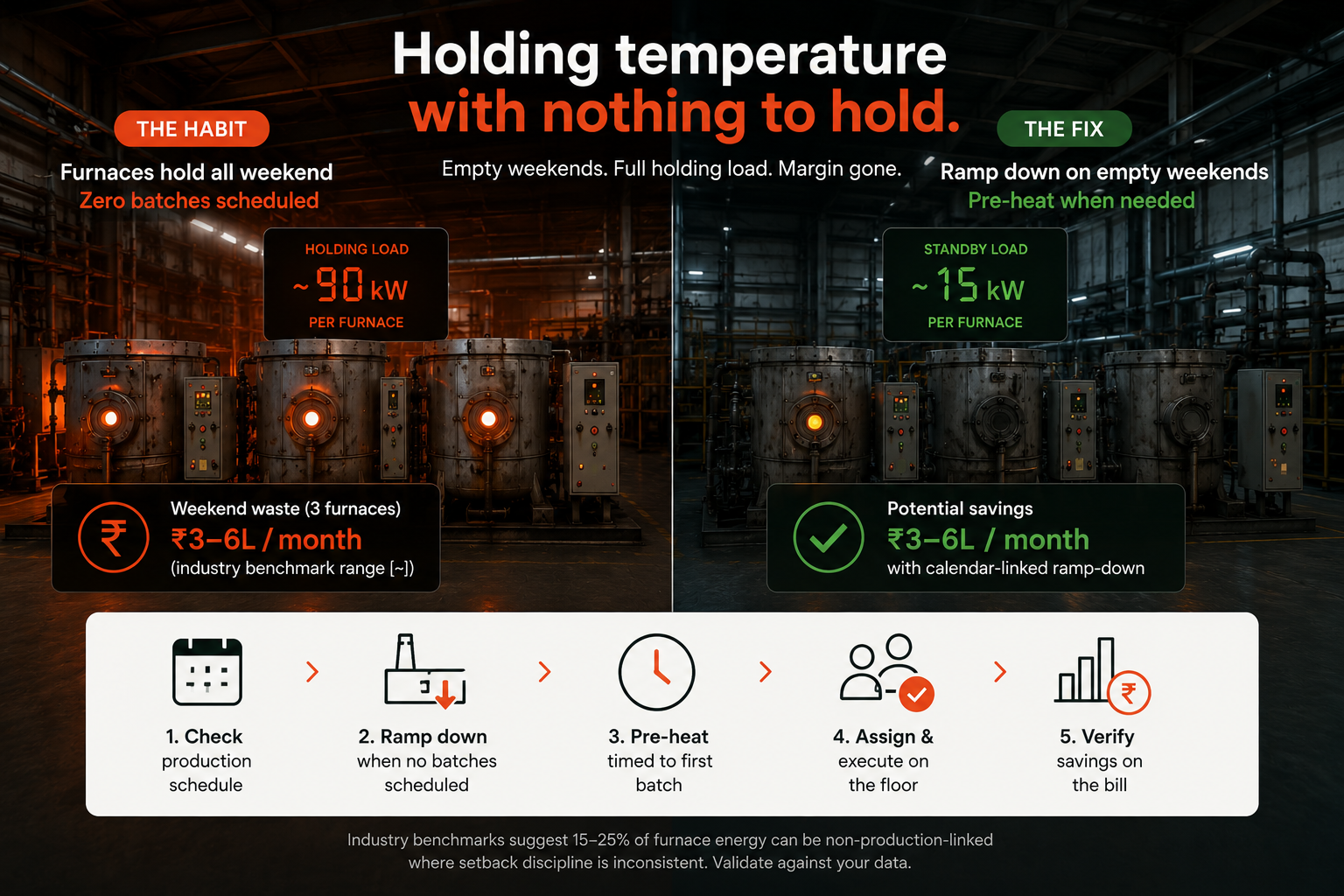

Holding Temperature with Nothing to Hold


Why the habit persists

Three reasons weekend hold survives every cost review:

  1. Monday risk — "We cannot afford a four-hour re-heat" is the default objection

  2. Fixed clocks — pre-heat starts at 06:00 because it always has, not because the first batch is at 08:30

  3. Siloed data — SCADA sees temperature; production planning sees batches; nobody owns calendar-linked energy

Your HT SCADA does its job. It holds soak. It does not read next week's dispatch list and ask whether Friday's hold is still justified.

EMS shows kWh trending flat over the weekend. It rarely outputs: "Ramp down Furnace 2 by Sunday 18:00 — zero batches confirmed — save ₹85,000 this month."

Safe ramp-down: calendar-linked prescriptions

The objection is always Monday morning. The answer is not "run cold all weekend." It is prescriptions tied to confirmed schedules:

  1. Correlate furnace registers with confirmed batch schedules 36 hours out (MES, ERP export, or supervisor sheet)

  2. Ramp down when no batches are scheduled before Sunday 18:00 (threshold agreed with HT lead)

  3. Pre-heat Monday timed to first confirmed batch, not a fixed 06:00 clock

  4. Assign owner — HT operator + shift electrical supervisor

  5. Verify — non-production furnace kWh week-over-week; energy units line on next bill

Plants that adopt this pattern often see ~60% reduction in weekend holding hours without missing Monday dispatches (industry benchmark from shops that implemented calendar-linked setback; your ramp curves and alloy rules may differ).

Prescription shape that changes behaviour:

> Furnace 3: No batches scheduled Sat–Sun per production plan #4471. Ramp to standby at 19:00 Friday. Pre-heat from 05:30 Monday for 07:00 batch start. Estimated ₹72,000–95,000/month vs full weekend hold. Owner: HT shift lead. Verify: furnace kWh Sat–Mon vs prior four empty weekends.

That is actionable. A kWh dashboard is not.

Worked example: empty weekend, full hold

Situation: Three batch furnaces at Binola-class HT shop. Production schedule confirms no Saturday or Sunday loads by Thursday 16:00. All three furnaces remain at soak from Friday 20:00 through Sunday 23:59. First batch Monday 07:30.

SCADA view: Temperature stable. Alarms quiet.

Stamped prescription (illustrative):

Field

Example

What

Furnaces 1 and 2 to standby Sunday 18:00; Furnace 3 holds for Mon 07:30 batch only

Why

4 of last 5 empty weekends showed 90+ kW holding load with zero batch IDs in MES

Who

HT operator + electrical supervisor

Effort

SOP update; no capex

Impact

₹1.2–2.0L/month furnace energy (benchmark range; pilot calibrates)

Verify

Weekend furnace kWh vs same-week production volume; bill energy units line

The production calendar already knew it was waste. The energy layer should have said so on Friday.

Verify on the bill

Plant heads need a number finance will believe. Practical approach:

Step

Method

Baseline

Non-production furnace kWh for weekends with zero batches (4–8 week window)

Action

Execute calendar-linked ramp-down prescriptions

Compare

Same calendar weeks prior year, adjusted for production volume (IPMVP-style [~])

Reconcile

Energy units and, where relevant, MD line items on DISCOM bill

Stamped Energy maintains a running ₹ ledger: potential vs realized savings reconciled to bill line items, not estimated project slides.

Read-only integration first: incomer meter, HT SCADA tags, utility bills, production signals where available. No furnace control writes in phase one.

See the full loop on How It Works.

What to check this week

You can sanity-check the hypothesis before any software rollout:

  • Pull last 8 weekends from production schedule: how many had zero confirmed batches?

  • For those weekends, pull furnace kWh or kW hold from SCADA or sub-meter

  • Note Monday pre-heat start time vs first actual batch time

  • Multiply hold kW × empty hours × your blended rate

If more than one-third of weekends run full hold with no batches, benchmarks suggest ₹3–6L/month may be in play for a three-furnace shop at typical HT tariffs [~]. Your data replaces the range.

How Stamped closes the loop

Layer

What you likely have today

What Stamped adds

Data

HT SCADA, incomer meter, bill PDF, MES/schedule export

Furnace state aligned to batch calendar

Insight

Temperature trends, shift notes

Non-production kWh flagged with ₹/month

Action

Tribal "we always hold" rules

Prescriptions with owner, ramp window, effort

Proof

Estimated conservation projects

Verified ₹ on bill energy units line

For the HT shop manager: Monday dispatch protected by batch-timed pre-heat, not blind hold.

For the CFO: Weekend waste quantified and tracked, not debated in quarterly review.

For the electrical head: read-only SCADA and meter integration; no controller writes in pilot.

Bottom line

Weekend furnace holding is a habit, not a requirement. Your production calendar already knows when no parts are scheduled. Your energy layer should turn that into assigned ramp-downs with ₹ on the ticket and proof on the next bill.

Industry benchmarks put 15–25% of furnace energy and ₹3–6L/month at risk where empty weekends still run full soak (typical three-furnace batch shop, HT tariff band [~]). Calendar-linked prescriptions can cut weekend holding hours sharply without missing Monday dispatches.

Quantify empty weekends first. Prescribe ramp windows second. Verify on the bill third.

Book a discovery call — we review your last three bills, weekend SCADA pattern, and whether a single-plant pilot is justified. If the numbers do not support it, we say so.
